No one expects council to complete its proposed infrastructure works in the space of a year or two. That does not mean that essential projects be held off for nearly a decade whilst developers get the go ahead to literally reach for the skies.

Council’s draft Strategic Resource Plan/Budget has some startling figures. We quote directly from these documents and ask that residents carefully consider the consequences of what this means.

ELSTERNWICK

  • Elsternwick Community Hub & Park – $32.45m (majority of spend in 2024-25 -to 2026-27).
  • Stanley Street East Multi-deck Car Park – $18m (majority of spend in 2023-24 – to 2024-25).
  • Selwyn Street Cultural Precinct – $1.2m (to be completed in 2023-24).

BENTLEIGH

  • Eat Street (Rotunda) – $2.55m (to be completed in 2020-21).
  • Bentleigh Library Upgrade – $2.9m (to be completed in 2023-24).
  • Horsley Street Multi-deck Car Park – $14.05m (majority of spend in 2027-28).

CARNEGIE

  • Koornang Road Streetscape Upgrade & Pedestrianisation – $6.45m (majority of spend in 2023-24 to 2025-26).
  • Shepparson Avenue Market Development – $2.95m for design, concept plans and initial consultation.
  • Kokarib Road Park – $50k for design works.

What these figures reveal is that residents will have to wait at least 10 years for most of these things to be completed. Given council’s track record on time lines and budget blowouts we expect the time lag and cost to be even more than indicated here.

No information is provided on:

  • Business case(s)
  • How costings were derived
  • Reasons for delay(s)
  • Percentage of third party involvement and their ‘contribution’

Even more discouraging is the fact that no dates are provided anywhere in the SRP or the Community Plan for the completion and introduction of such vital amendments as:

  • Car parking overlays
  • Infrastructure levies on development
  • Increase of open space levies

Much of what is proposed has not been ‘endorsed’ by residents. Do residents really want to spend $14m for a high rise concrete car park in Bentleigh or $18m for one in Elsternwick? What ‘evidence ‘ is there that this will solve parking problems in these areas? Is this really ‘value for money’ or simply ‘value’ for developers when council land will be sold off? And do residents really want to be in hock again to the tune of an additional $30m  that council wants to borrow?

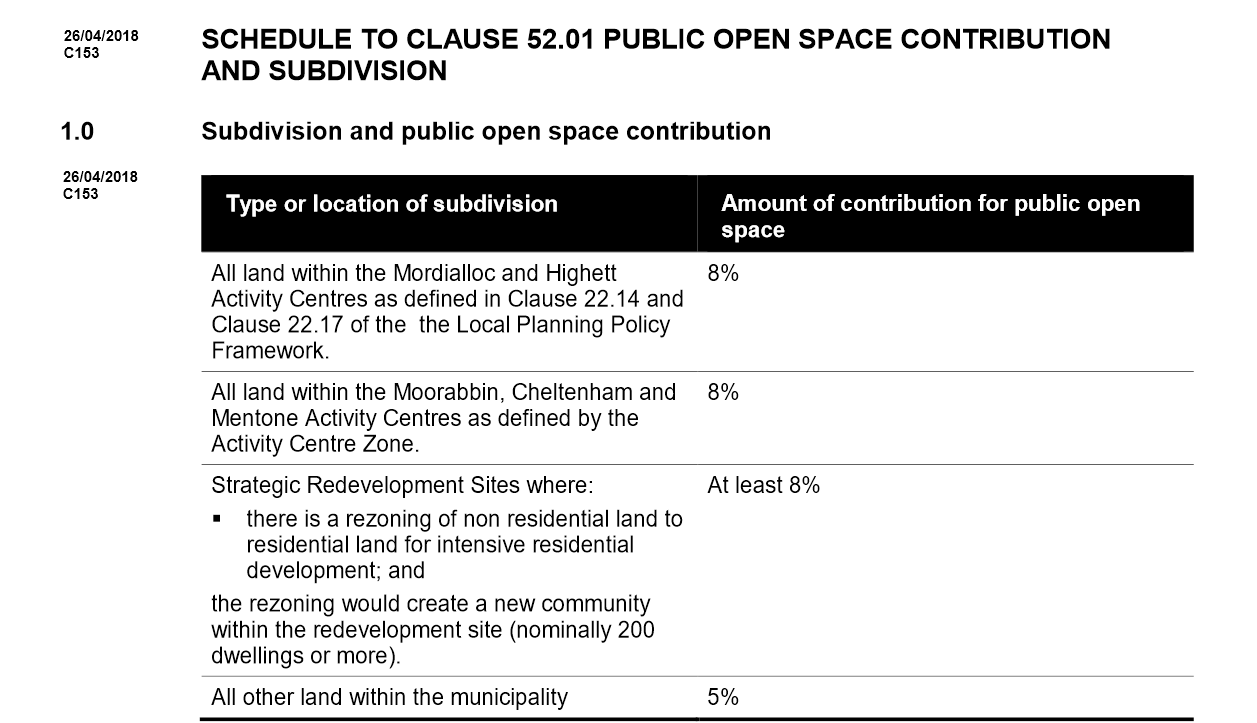

PS: As an example of what can be achieved right now (if there’s the will) the following Kingston amendment was gazetted a few days ago.
